Power Quality Evaluation: The Cornerstone of Stable Solar
PV System Operation
As solar photovoltaic (PV) systems gain widespread adoption in commercial and industrial settings, interest in financial returns and performance expectations has intensified. However, a critical yet often overlooked aspect throughout the entire lifecycle of solar projects—from planning and installation to operation and maintenance—is comprehensive power quality (PQ) evaluation. Whether diagnosing grid conditions prior to installation or assessing post-commissioning impacts, thorough PQ testing helps stakeholders mitigate risks, optimize performance, and ensure compliance with industry standards and warranty requirements. Drawing insights from the real-world Xalapa, Mexico PV project, this article delves into the strategic value and practical implementation of power quality evaluation in solar systems.
Core Understanding of Power Quality in Solar Contexts
Power quality refers to the stability and purity of electrical power supplied to equipment or distributed across a grid. Key evaluation metrics include voltage regulation accuracy, harmonic content, voltage flicker, and transient surges. While these concepts may seem abstract, they directly impact the safety of solar operations: interactions between PV inverters and the grid can introduce harmonics or voltage fluctuations, while abnormal grid conditions may trigger inverter shutdowns—compromising energy output and potentially damaging high-value core components. The complexity of PQ issues in solar systems is particularly pronounced. On one hand, inverter conversion efficiency and control strategies directly influence the quality of output power. On the other hand, pre-existing grid flaws (such as three-phase imbalance or excessive background harmonics) can compound with PV integration, amplifying problems. Without systematic PQ evaluation, pinpointing the root cause of failures becomes challenging—whether issues stem from the PV system itself, pre-existing grid defects, or their interaction—inevitably increasing dispute resolution costs and operational downtime.
Mandatory Power Quality Standards for Solar Projects
PQ evaluation is guided by a framework of authoritative industry standards that define compliance for solar installations:
- IEEE 1547 Series Standards: Widely adopted globally for interconnecting Distributed Energy Resources (DERs) with power systems. The 2020 amendment, IEEE 1547.1-2020, further clarifies conformance testing requirements, mandating the use of IEC 61000-4-30 Class A-compliant PQ meters for measuring voltage, current distortion, and other critical parameters.
- IEC 61000-4-30 Standard: Specifies performance requirements for PQ measurement equipment. Class A meters, renowned for high precision, are the gold standard for solar project PQ assessments.
- IEEE 519 Standard: Establishes harmonic control limits for power systems. Solar installations must strictly adhere to these limits to avoid adverse impacts on the grid and adjacent equipment. These standards form the "red line" for PQ compliance, serving as the technical foundation for grid safety and reliable solar operation.
The Xalapa Project: Practical Insights from PQ Evaluation
The rooftop pergola PV project in Xalapa, Mexico, offers compelling evidence of PQ evaluation's importance. With a capacity of 16kW AC / 16.35kW DC and two single-phase inverters (10kW and 6kW), the project underwent comprehensive joint PQ and PV performance testing using professional equipment:
- Seaward PV210 IV-curve Tracer: Specialized for verifying solar module performance consistency and identifying potential defects.
- Dranetz HDPQ Xplorer Plus: A portable, IEC 61000-4-30 Class A PQ meter delivering high-precision data collection.

Key Findings and Risk Alerts
1. PV Module Performance Defects: IV-curve testing revealed a performance anomaly in one of three solar strings. Such defects—potentially caused by soiling, shading, or hardware failure—would have persisted undetected without testing, compromising long-term energy output and posing overheating risks.

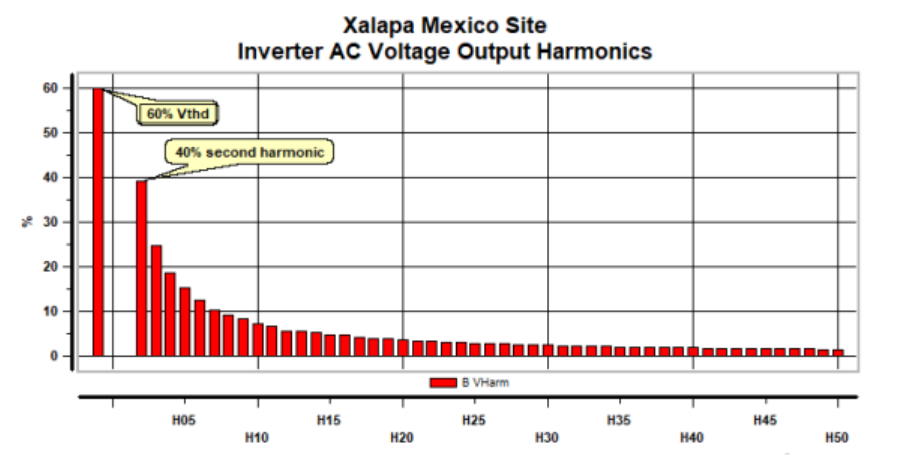

2. Severe Harmonic Violations: PQ measurements indicated inverter AC output harmonics far exceeded IEEE 519 limits, with Total Voltage Harmonic Distortion (Vthd) reaching 60%. Unusual even-order harmonics (rare in most power systems) were also detected. Excessive harmonics can cause overheating in inductive equipment (e.g., transformers), resonance, elevated neutral currents, overvoltage, and eventual system shutdown—resulting in significant financial losses.

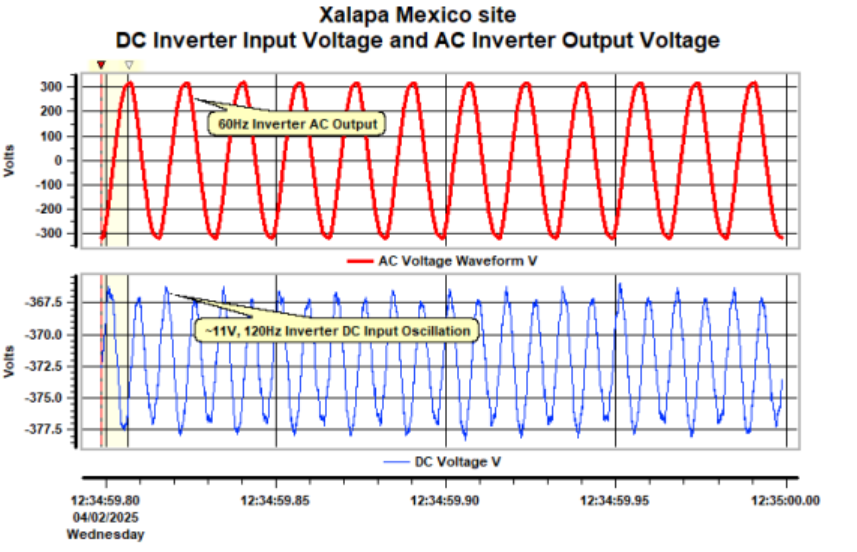

3. Abnormal DC-Side Oscillation: The inverter DC input exhibited an 11V oscillation at 120Hz (twice the grid's fundamental 60Hz frequency), likely linked to second-order harmonics on the AC side. This oscillation undermines inverter stability and accelerates component degradation. This case underscores that solar projects without PQ evaluation risk hidden operational hazards. Professional testing identifies these issues early, providing a data-driven basis for corrective action.
Best Practices for PQ Assurance in Solar Projects
Based on industry experience and real-world case, solar projects should implement a full-lifecycle PQ management system, focusing on six core practices:
1. Conduct Pre- and Post-Installation PQ Testing
Pre-installation testing establishes a grid "baseline," identifying pre-existing PQ issues and shielding installers from unwarranted liability. Post-installation testing isolates PQ disturbances caused by PV integration, ensuring grid compatibility. This two-phase approach ("pre-installation baseline assessment and post-installation verification") is critical for compliance and safety.
2. Perform Annual PQ and Electrical Health Audits
Annual comprehensive PQ testing and electrical system health assessments enable early detection of potential issues, clarify fault responsibility, verify performance compliance, and ensure long-term reliability.
3. Establish Correlative Analysis Between PQ and System Performance
Incorporate PQ metrics into core operational monitoring. Analyzing relationships between harmonics, voltage fluctuations, energy output, and equipment failure rates enables predictive maintenance—shifting from reactive repairs to proactive prevention.
4. Integrate PQ Results into Acceptance and Warranty Protocols
Make PQ test reports a core requirement for project acceptance. Define PQ-related criteria in warranty agreements to strengthen accountability among suppliers, installers, and owners, ensuring effective issue traceability. 5. Install Fixed PQ Meters for Critical Applications
For large-scale projects, complex grid environments, or sites with a history of PQ issues, fixed PQ meters are recommended. Despite higher upfront costs, they provide continuous, consistent data on PQ events, supporting informed operational decisions.
6. Systematically Document Compliance and Warranty Evidence
Maintain comprehensive technical records, including PQ test data and compliance reports. These documents serve as essential documentation for regulatory inspections and warranty claims, protecting the interests of all project stakeholders.
